Construction
Jul 2, 2026

The Homeowner’s Checklist: Understanding Progress Payments and Payment Schedules

The Homeowner’s Checklist: Understanding Progress Payments and Payment Schedules

Building a high-end custom home is a significant financial undertaking.
Unlike a standard off-the-plan build, custom residential projects often involve complex architectural details, premium materials, and multi-stage payment structures that can span several years.

For the homeowner, the most critical "business" aspect of the project occurs when a progress claim lands in your inbox. In Australia, the legal and contractual framework surrounding these payments is strict. If you are a respondent to a payment claim, you cannot simply ignore an amount you disagree with. You must provide a formal Payment Schedule.

At Shoal Bay Projects, we specialize in guiding homeowners through these technicalities, ensuring that every dollar paid aligns with the actual value of work performed on-site. This checklist serves as your roadmap to managing cashflow, mitigating the risk of "front-loading," and understanding your rights under the Security of Payment legislation.

1. The Anatomy of a Progress Claim

A progress claim is more than just an invoice. In the context of a high-end build, it is a formal demand for payment for work performed during a specific period or upon reaching a defined milestone.

Most premium builds utilize contracts such as AS 4906 (Minor Works) or tailored residential agreements that include specific provisions for payment claims. Under the Security of Payment Act (which varies slightly by state but maintains core national principles), a valid payment claim must:

  • Identify the specific construction work or related goods and services.
  • State the amount of the progress payment that the builder claims is due.
  • In many cases, state that it is a "Payment Claim made under the Building and Construction Industry (Security of Payment) Act."

Check: Ensure the builder has attached any required "Homeowner's Notice" if your project value exceeds the statutory threshold (e.g., $500,000 in certain jurisdictions). Without this notice, the claim may be invalid under the Act, though you may still be contractually liable.

2. The Danger of "Front-Loading"

"Front-loading" occurs when a builder allocates a disproportionately high value to the early stages of a project: such as site establishment, demolition, or the initial slab: relative to the actual cost of those works.

Why is this a risk for you?

If you overpay in the first 20% of the project, you lose your financial leverage. Should the builder face insolvency or abandonment issues mid-way through the build, you will find that the remaining funds in your budget are insufficient to pay a new contractor to finish the work.

Specify: Always compare the claimed percentage of a stage against the physical reality. If the builder claims 100% of "Preliminaries" in the first month, they are front-loading their profit.

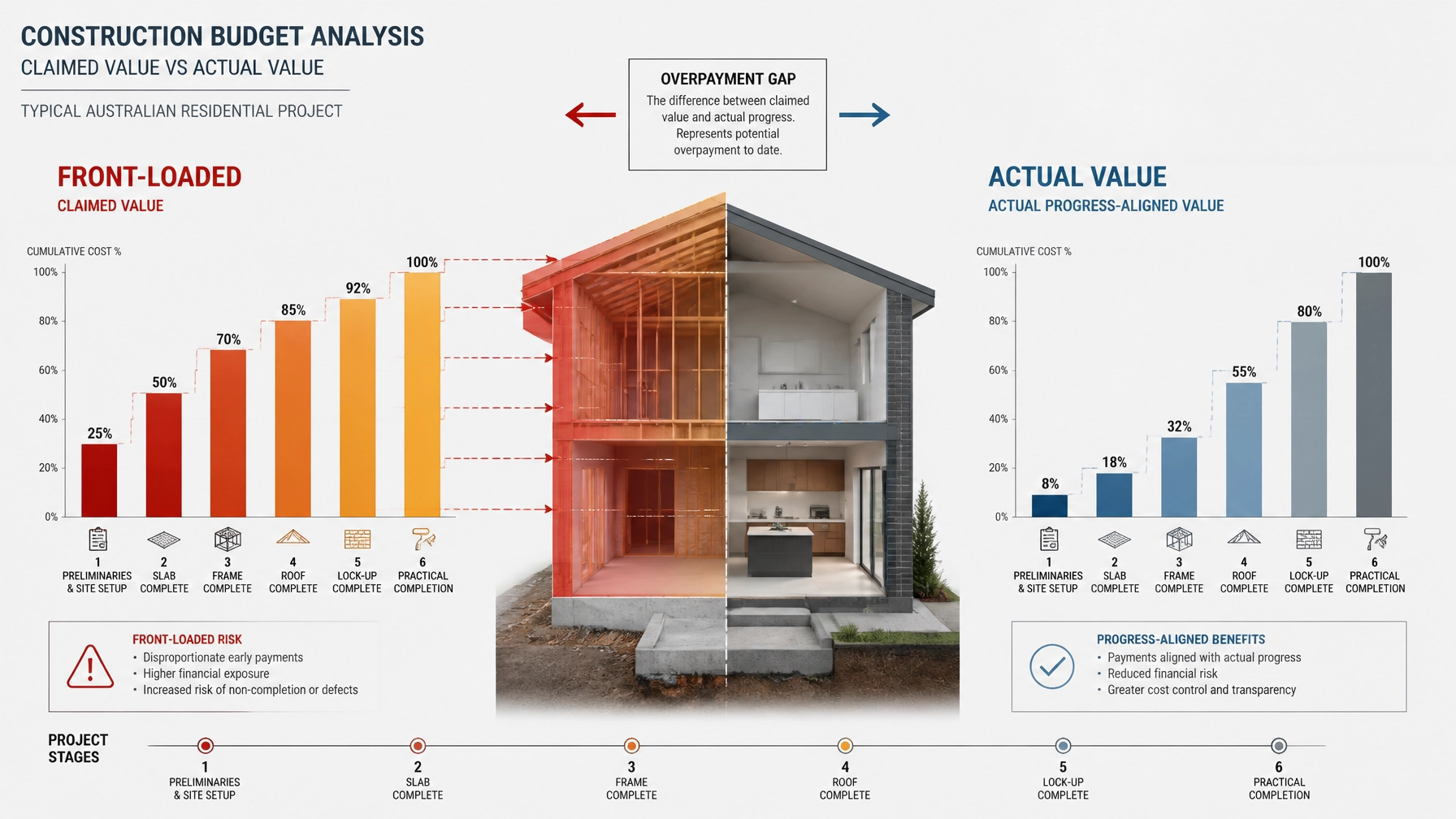

A high-quality 3D forensic diagram showing a split-view of a construction budget: on one side, a Front-Loaded bar chart showing high early spending; on the other, an Actual Value chart showing costs aligned with site progress. Arrows highlight the Overpayment Gap.

3. Your Mandatory Shield: The Payment Schedule

If you receive a progress claim and you do not intend to pay the full amount, you are legally obligated to provide a Payment Schedule.

This is not a casual email saying, "I'll pay you next week." A Payment Schedule is a formal document that:

  1. Identifies the payment claim to which it relates.
  2. States the "Scheduled Amount" (the amount you intend to pay).
  3. If the Scheduled Amount is less than the Claimed Amount, it must provide reasons for the difference.

Document: In many Australian jurisdictions, you have a strict window: often 10 to 15 business days: to serve this schedule. If you miss this deadline, you may become automatically liable for the full amount of the builder's claim, regardless of whether the work was actually done or if it was defective.

Common reasons for withholding payment in a schedule:

  • Overvaluation: The work claimed is 80% complete, but the builder has claimed 100%.
  • Defective Work: Work has been performed but does not meet the standards of AS 3740 (Waterproofing) or AS 2870 (Residential Slabs and Footings).
  • Unapproved Variations: The claim includes costs for variations that were not signed off in writing as per the contract.

4. Managing Cashflow on Custom Builds

In a high-end project, cashflow management is about protecting your "cost-to-complete." You need to ensure that at every stage of the build, the remaining contract sum is enough to pay another builder to finish the house if your current builder disappears.

Verify: Before making any payment, cross-reference the claim against the Bill of Quantities (BoQ) or the Schedule of Rates. If your contract is "Lump Sum," check the percentage completion against the agreed milestones.

Close-up of a residential roof corner showing annotated labels for compliance, with a digital clipboard overlay showing a 'Progress vs Payment' audit checklist.

5. The Value of Strategic Consultation

For most homeowners, assessing whether a "Plateau Level" masonry claim is technically accurate is impossible. This is where Shoal Bay Projects provides a critical layer of defense.

We operate at the advisory level to:

  • Audit Progress Claims: We visit the site to verify that "70% completion of services" is a reality, not just a figure on a page.
  • Draft Payment Schedules: We help you articulate technical reasons for withholding payment, ensuring your schedule is robust enough to withstand adjudication or legal dispute.
  • Identify Variation Creep: We ensure that builders aren't using progress claims to sneak through unapproved costs.

Seek Advice: If a builder serves a claim under the Security of Payment Act, the clock is ticking. Engaging a consultant early allows you to respond with precision rather than emotion.

6. Your Step-by-Step Payment Checklist

Follow these steps every time a claim arrives:

  1. Timestamp the Receipt: Mark exactly when you received the claim. This sets your legal deadline for the Payment Schedule.
  2. Verify the Format: Does the claim meet the contractual requirements? Does it reference the Act?
  3. Conduct a Site Walk: Physically check the items claimed. If "Internal Linings" are claimed at 100%, are the sheets actually installed and finished according to AS 2589?
  4. Review the Variations: Check for any "extra" costs. If you haven't signed a variation order, they should not be in the claim.
  5. Draft the Schedule: Even if you only disagree with $500 of a $50,000 claim, you must document it.
  6. Consult the Experts: Send the claim to Shoal Bay Projects for a compliance and progress review.

Architectural plans on a desk with a blue 'Building Permit' folder, symbolizing the intersection of regulatory compliance and financial authorization.

Conclusion: Empowerment through Accuracy

Progress payments should be a celebration of a milestone reached, not a source of anxiety. By understanding the requirement for a Payment Schedule and the risks of front-loading, you move from a passive "payer" to an active "project manager" of your own investment.

Protect your project, maintain your leverage, and ensure your high-end build remains a legacy of quality rather than a lesson in financial risk.
