Why the 2025 Compliance Rules Will Change the Way You Detail Your Next Build

Why the 2025 Compliance Rules Will Change the Way You Detail Your Next Build

For residential builders and homeowners alike, the goalposts for "compliant construction" are shifting. As of May 2025, the industry has transitioned into a new era of performance requirements under the National Construction Code (NCC). While the delay of the full NCC 2025 edition led to the release of NCC 2022 Amendment 1, the technical requirements for moisture management and structural detailing have never been more rigorous.

At Shoal Bay Projects, we operate at the advisory level, helping our clients navigate these complex regulatory updates. If you are planning a high-end residential build or a major renovation, understanding the nuances of AS/NZS 3500.3:2025 and the specific variations for window installations in masonry is no longer optional: it is a critical part of your risk management strategy.

The Guttering Revolution: Designing for Total Blockage

The most significant change in the May 2025 updates concerns how we handle stormwater at the eaves. Historically, roof drainage design assumed that downpipes would function as intended. The new standards under AS/NZS 3500.3:2025 (Plumbing and drainage – Stormwater drainage) flip this assumption on its head.

Now, eaves gutter overflow measures must be designed assuming that all downpipes are fully blocked. This "worst-case scenario" detailing is a forensic approach to preventing water ingress into the building envelope during extreme weather events.

Key Changes to Eaves and Valley Gutters

  • The 1% AEP Mandate: Overflow systems must now be designed for an Annual Exceedance Probability (AEP) of 1%. This significantly raises the performance bar for overflow measures compared to previous "generic" solutions.
  • Mandatory Appendix F: What was once informative guidance is now normative (mandatory). You must calculate overflow volumes using the prescribed formulas in Appendix F to achieve a Deemed-to-Satisfy (DTS) solution.
  • Front Bead Overflow: Specify a front bead that is at least 10mm below the fascia. Under the new rules, this allows for a calculated overflow capacity of 1.5 L/s per metre, providing a clear pathway for water to exit without entering the roof cavity.

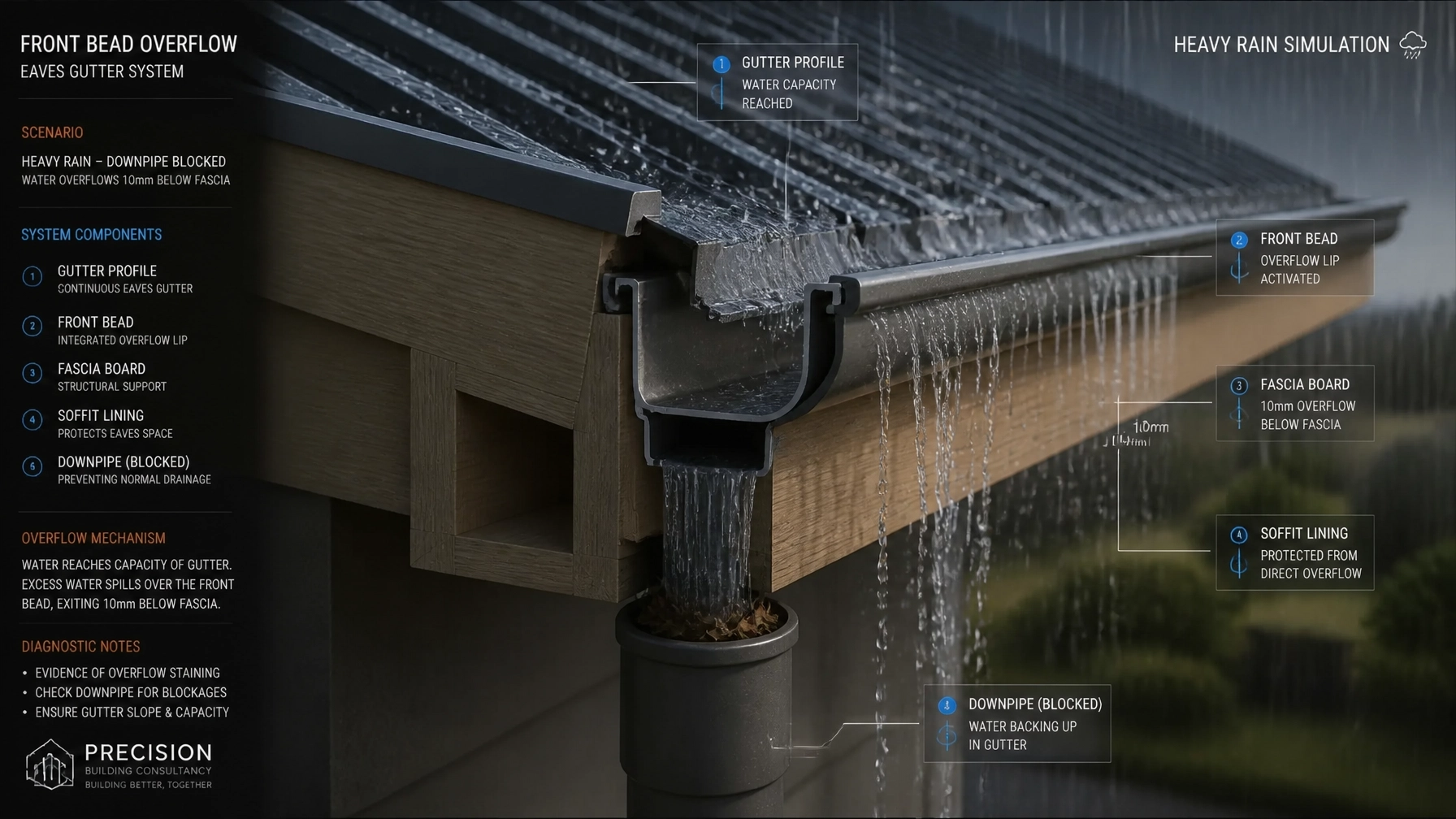

Technical 3D rendering of an eaves gutter system showing a front bead overflow mechanism with water overflowing below the fascia

Document your gutter profiles early. If you are relying on slotted gutters, ensure the slot capacity exceeds the calculated overflow volume for your specific roof catchment area. Check that valley gutters do not exceed the new maximum catchment area of 40m² (up from 20m²), but exercise caution with current graphs in the standard due to known editing errors in Figure 3.6.2.

Window Head Detailing: The 10mm Gap Conflict

One of the most frequent points of contention in residential project management is the detailing of window heads in masonry construction. Under the standard NCC Housing Provisions (Part 8.2), a minimum gap of 10mm is required between the head of the window and the nearest loadbearing element (usually the lintel).

This gap is designed to prevent structural loads from being transferred onto the window frame, which can lead to glass breakage and operation failure. However, the moisture management implications are equally critical.

Navigating the Western Australia Variation

In Western Australia, a specific state variation (Industry Bulletin 168) now allows for this gap to be less than 10mm in masonry construction, provided it is still sufficient to prevent load transfer.

Specify the head gap clearly in your architectural drawings. Even with a reduced gap in WA, you must still maintain the integrity of the flashing and damp-proof course (DPC).

  • AS 2047 Compliance: Ensure windows comply with AS 2047, which mandates that flashing must comply with AS 4773.2.
  • Sealant Depth: Maintain a correct width-to-depth ratio for flexible sealants. As shown in our forensic detailing guides, a 10mm expansion gap should be supported by a closed-cell PE backing rod to ensure the sealant can handle thermal movement without tearing.

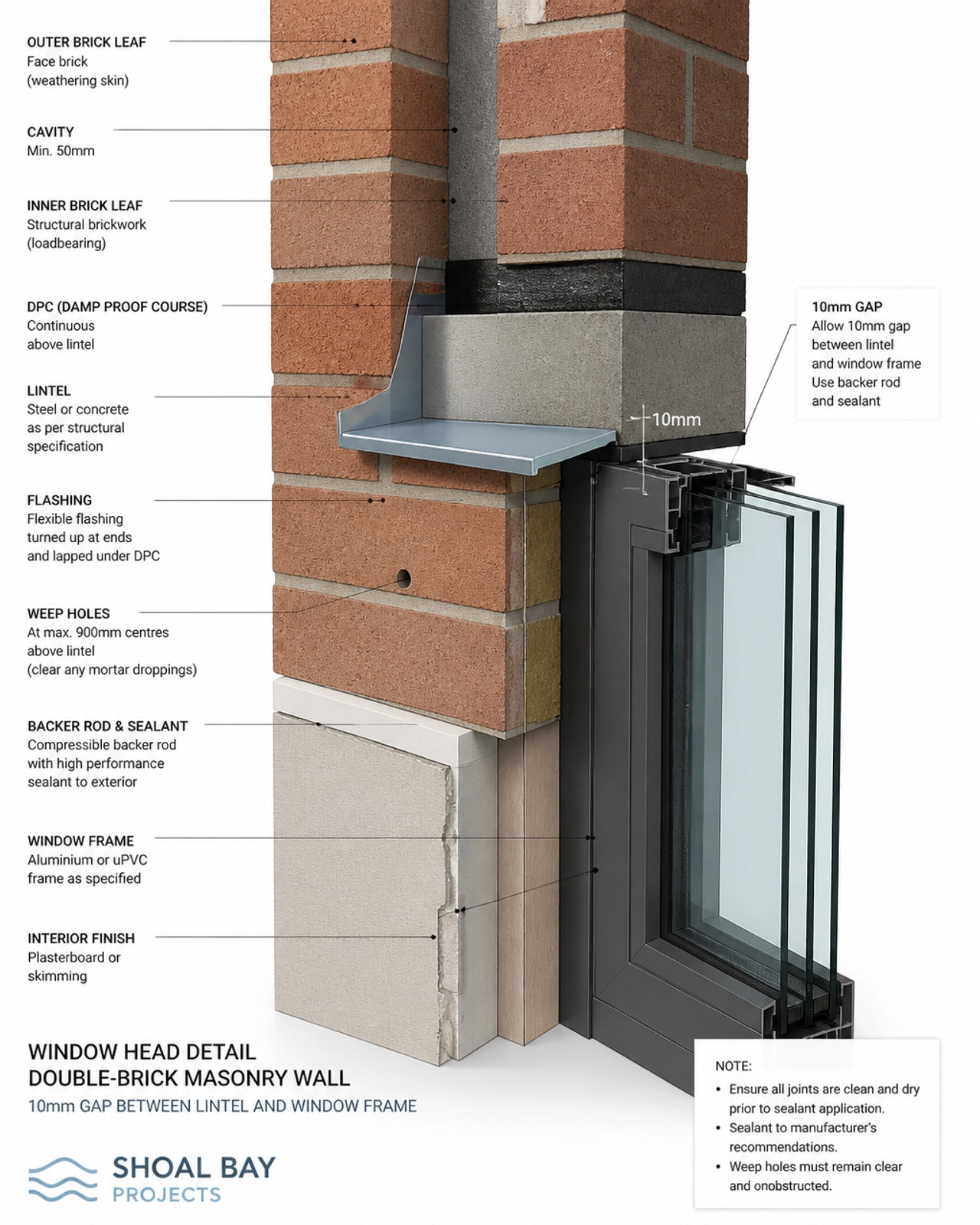

Forensic 3D technical illustration of a window head in a masonry wall showing the 10mm gap and flashing details

Moisture Management as a System

Compliance isn't just about passing an inspection; it’s about asset protection. Moisture ingress remains the leading cause of building disputes in Australia. To combat this, your detailing must move beyond individual components and look at the "Systemic Failure Cascade."

For example, a failure in the gutter overflow system doesn't just result in a wet fascia; it often leads to water tracking back into the window head, bypassing the flashing, and causing internal dampness that can stay hidden behind plasterboard for years.

Best Practice Detailing Checklist

  1. Integrate Ember Mesh: In BAL-rated areas, ensure your eave vents include 2mm stainless steel ember mesh per AS 3959. This protects against both fire and vermin without compromising ventilation.
  2. Visible DPCs: Ensure Damp Proof Courses are visible at both faces of the wall and sit at least 150mm above adjacent finished ground level (or 75mm above paved areas).
  3. Expansion Joints: Detail expansion joints in fibre cement cladding with a minimum 10mm gap and UV-stable sealant. This prevents the "bowing" effect that can breach weather membranes.

Detailed cross-section showing the assembly of a fibre cement cladding expansion joint with a 10mm expansion gap

Strategic Consultation: The Shoal Bay Projects Edge

Navigating the transition from NCC 2022 to the 2025 standards requires more than just a copy of the code; it requires construction compliance interpretation.

Shoal Bay Projects provides structured, compliance-focused building consultancy services for those who cannot afford to get it wrong. We don't just tell you what the rule is; we help you specify the correct technical detail to ensure your project remains aligned with contractual and performance requirements.

Our residential project management advisory helps builders and homeowners identify risks before the first brick is laid. Whether it’s reviewing soil investigation reports to manage site stratification risks or auditing window flashing details, our focus is on protecting the financial and reputational integrity of your build.

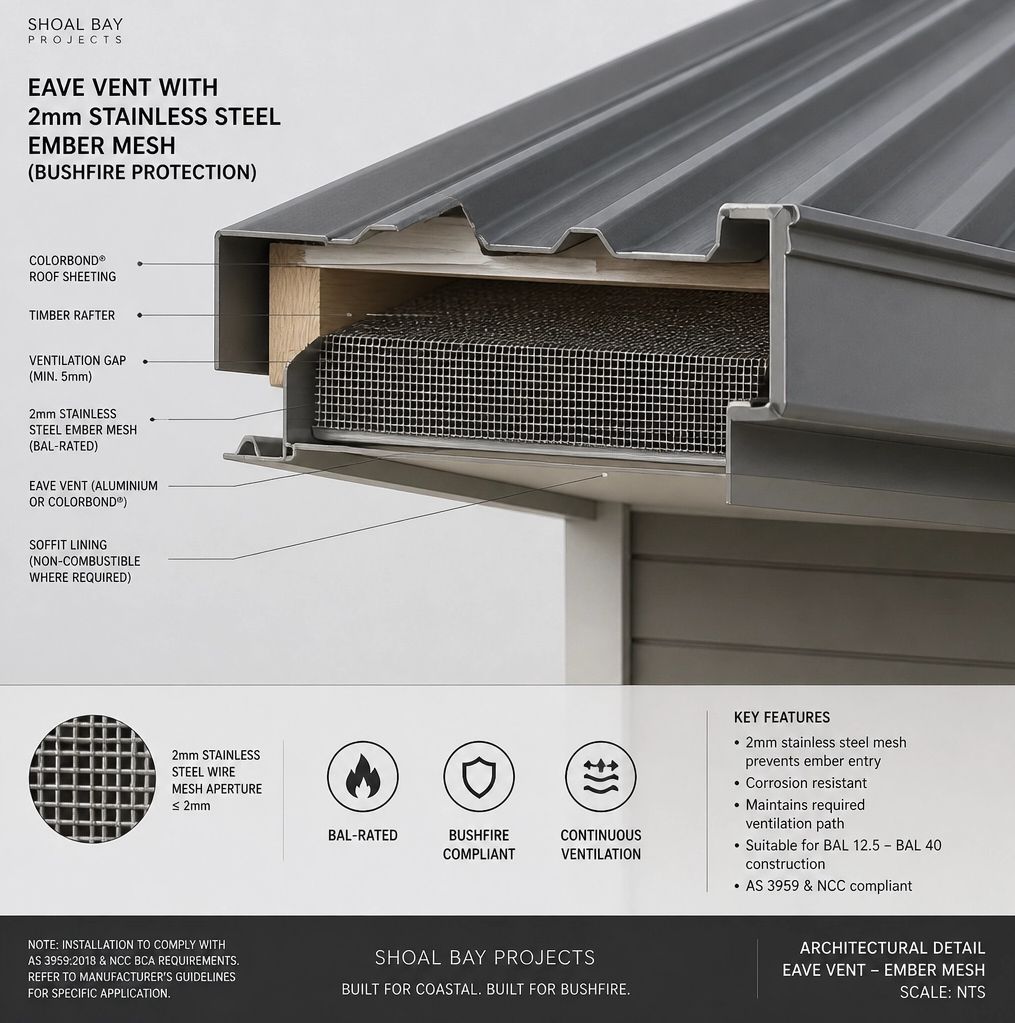

Detailed architectural detail showing an eave vent system with 2mm BAL-rated stainless steel ember mesh

Welcome to the Hive

At Shoal Bay Projects, we believe that informed decision-making is the best form of risk management. We invite you to join our growing community of builders and property owners who are committed to construction excellence.

Explore "The Hive" and "The Vault": our community hubs where we break down the latest Australian Standards and compliance updates into actionable insights.

Watch our invitation here: Welcome to the Hive


get in touch

Subscribe to our newsletter

Lorem ipsum dolor sit amet consectetur senectus velit faucibus non quisque at ut vitae platea justo nec mattis.

Thanks for joining our newsletter.
Oops! Something went wrong.
Subscribe To Our Newsletter - Construcfy X Webflow Template
